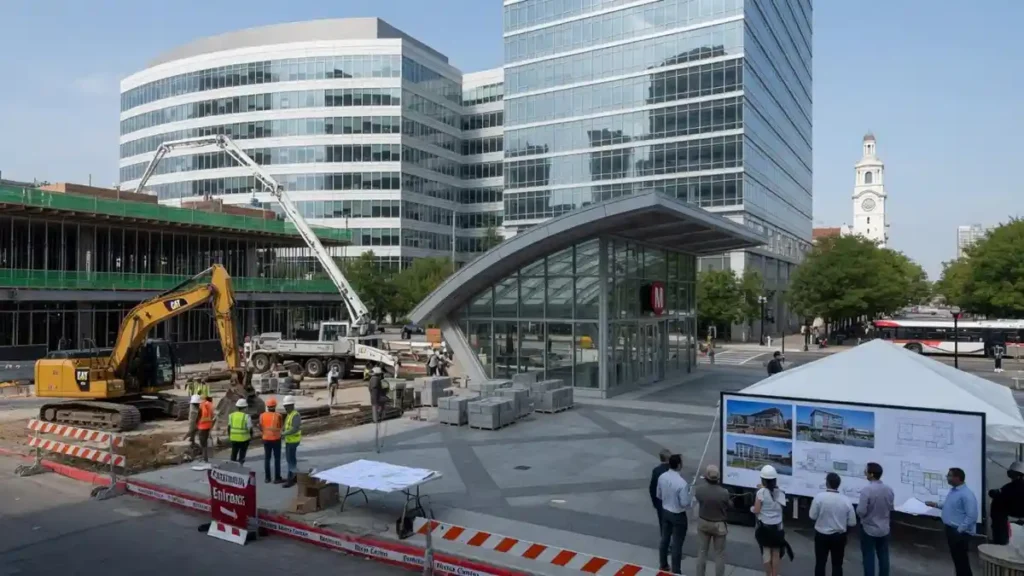

The bethesda metro center bethesda md upgrades finished on time and on budget in September 2026, and the lessons matter far beyond one station. For developers, project managers, and owners, this site shows how durable concrete, tight access planning, and phased delivery protect schedules and budgets.
Key Takeaways
- Bethesda station’s new 6,000-square-foot mezzanine used about 60 tons of steel and 220 cubic yards of concrete to prep for the Purple Line.
- Crews removed 148,000 pounds of concrete in a 44-hour weekend shutdown using a remote-controlled demolition robot.
- Full Red Line service resumed Sept. 7, 2026 after a nine-week closure, finished on time and on budget.
What the San Francisco 49ers Stadium Teaches Precast Pros
Overview
Bethesda, Maryland anchors one of the busiest transit corridors in the Washington region. The area pairs premium office space with heavy Metrorail traffic. At Midwest Precast Contractor, we study projects like these to sharpen our own delivery.
Our focus is simple. We build strength and craft excellence. The recent work here proves that precast concrete, careful sequencing, and weather-resistant materials win when downtime costs real money.
Why This Site Matters
3 Bethesda Metro Center is a 16-floor, 368,000-square-foot office building. It was built in 1985 and offers direct, covered access to Bethesda Metro. That connection is the whole point.
If you have been tracking transit-oriented development, this pairing will not surprise you. Owners want walkable access, tenants want reliability, and both want zero surprises during renovations.
Quick building facts:
| Feature | Detail |
|---|---|
| Floors | 16 |
| Size | 368,000 sq ft |
| Year built | 1985 |
| Floor plate | ~26,000 sq ft |
| Transit link | Direct covered Metro access |
| Amenities | Conference center, fitness center, rooftop terrace |
Our hands-on engineering experience shows that buildings tied to transit outlive isolated ones.
What Newpathconstruction Com Leadership Team Teaches Owners
Current 2026 Construction Context
Metro closed the Red Line from North Bethesda to Friendship Heights starting July 6, 2026. The nine-week shutdown wrapped up with a full reopening on Labor Day weekend, with service back Monday, Sept. 7.
Industry contractors are noting the smart timing. Metro closed after the Fourth of July when ridership sits lowest. That single choice compressed two years of weekend work into two months.
What got done:
- New mezzanine at Bethesda for the future Purple Line
- Rehabilitated Grosvenor-Strathmore platform
- Aerial structure work along closed track
- 1.2 million riders moved by free shuttle buses
That is phased delivery done right.

Structural and Transit Engineering Implications
The Bethesda station mezzanine is roughly 6,000 square feet. It adds two new escalators, two new elevators, a station manager kiosk, and new faregates. It creates a second entry point and a bridge toward the Purple Line.
Why this matters for owners: more access points mean higher tenant value and safer crowd flow. The Maryland Transit Administration’s 16-mile Purple Line will link 21 stations, with transfers at Bethesda targeted for late 2027.
| Transit Interface Element | Metric |
|---|---|
| New mezzanine size | ~6,000 sq ft |
| Escalators added | 2 |
| Elevators added | 2 |
| Steel used | ~60 tons |
| Concrete used | 220 cubic yards |
| Purple Line service target | Late 2027 |
Per FHWA guidance on transit access, redundant vertical circulation improves both safety and throughput.
Materials and Specifications
Material choice decides whether a structure lasts decades or needs early repair. At Midwest Precast Contractor, we spec durable materials built for Midwest-tough weather. The same logic applies to any high-traffic transit build.
If you have been tracking precast concrete standards, this specification will not come as a surprise. PCI design guidance and ACI 318 requirements both stress cover, mix design, and load rating for long service life.
| Material | Durability | Load Capacity Relevance | Cost-Efficiency | Weather Resistance |
|---|---|---|---|---|
| Precast concrete | Very high | Excellent for heavy floor and platform loads | High over lifecycle | Excellent freeze-thaw performance |
| Cast-in-place concrete | High | Strong but cure-time dependent | Moderate | Good with proper curing |
| Structural steel | High | Excellent tensile strength | Moderate | Needs coatings for corrosion |
| Precast plus steel hybrid | Very high | Best combined performance | High | Excellent when detailed well |
We favor precast when speed and repeatable quality both matter.
What Bethesda Metro Center Bethesda MD Teaches Builders
— US News (@Us_news_ways) September 10, 2026
The bethesda metro center bethesda md upgrades finished on time and on budget in September 2026, and the lessons matter far beyond…@wmata @MontgomeryCoMD @bethesda https://t.co/yiNq81dEpQ
Precast vs Cast-in-Place Comparison
Both methods work. The right pick depends on schedule, site access, and quality control needs.
Precast concrete pros:
- Factory-controlled curing for consistent strength
- Faster field installation and less downtime
- Predictable quality and tight tolerances
- Strong freeze-thaw resistance for Midwest sites
Precast concrete cons:
- Higher upfront transport and crane needs
- Connection detailing must be precise
- Design coordination starts earlier
Cast-in-place pros:
- Flexible on complex shapes
- Fewer joints in some monolithic pours
Cast-in-place cons:
- Weather-sensitive curing
- Longer field schedule
- On-site quality variability
Our crews observed that transit sites reward precast because shutdown windows stay short.
Wilshire Grand Hotel Downtown LA A Build Study
Restoration and Retrofit Priorities
The Bethesda work sat next to historic coffered panels from the 1970s construction. Crews protected that original infrastructure while cutting new openings. That is restoration discipline.
Grosvenor-Strathmore shows the retrofit checklist clearly. Crews poured 280 cubic yards of concrete, laid 16,000 square feet of tile, and rebuilt platform edges for safety and rider experience.
| Restoration Scope | Grosvenor-Strathmore Metric |
|---|---|
| Concrete poured | 280 cubic yards |
| Tile installed | 16,000 sq ft |
| Globe lights | 108 |
| Edge lights | 288 |
| Wind shelters | 6 |
| Digital screens | 26 |
Owner takeaway: budget for edge repair, drainage, and lighting early. NIST research links preventive concrete maintenance to lower lifecycle cost.
Construction Sequencing and Safety Controls
The demolition here was a masterclass in control. Clark’s team removed 148,000 pounds of concrete inside a 44-hour weekend shutdown, reopening by 5 a.m. Monday.
With only a few inches of tolerance, crews used a remote-controlled robot to protect adjacent historic panels. That is precision under pressure.

Sequencing steps we recommend:
- Lock the shutdown window during lowest traffic.
- Protect adjacent structures with barriers and monitoring.
- Use remote demolition near sensitive elements.
- Stage precast for rapid installation.
- Verify reopening readiness before service returns.
| Risk | Control |
|---|---|
| Damage to historic panels | Robotic precision demolition |
| Rider disruption | Free shuttle buses, temporary bus lanes |
| Schedule overrun | Compressed shutdown, on-time targets |
| Worker safety | Barriers, monitoring, staged access |
Per OSHA standards, controlled demolition zones cut incident risk sharply.
Midwest Precast Contractor Approach
We bring the same standards to every job across Des Moines, Ankeny, West Des Moines, and beyond. Engineering precision, durable materials, and on-time delivery are not slogans for us. They are the plan.
Our process:
- Consultation to fix goals and constraints
- Planning and design tuned to budget
- Execution with transparent updates
- Final inspection against strict standards
We honor timelines because downtime costs you money. Whether it is precast systems, formwork, or structural framing, our licensed and insured crews build to last through Midwest-tough conditions.
Replacement Windows vs New Construction Guide
Final Assessment
The lessons from bethesda metro center bethesda md are clear and repeatable. Time your shutdowns, protect existing structures, and spec materials that beat the weather. That formula finished this work on time and on budget.
At Midwest Precast Contractor, we apply those same principles on every site. Strong foundations, precise engineering, and honest schedules protect your investment. When you are ready to build durable, ask us how precast can shorten your timeline and extend your building’s life.
