Ask a room of contractors how many people died in the construction of Hoover Dam, and you’ll hear a dozen different guesses.
The real answer matters now, because the hazards that killed workers in Black Canyon still show up on Midwest jobsites: heat, falling objects, toxic air, and rushed schedules.
Here’s what the record shows and what it means for your next pour.
Key Takeaways
- 112 deaths are officially tied to the project, with 96 occurring on-site, and 42 more workers were recorded as dying of “pneumonia.”
- Staged column pours and 582+ miles of cooling pipe solved a thermal problem that would otherwise have taken 125 years to cool.
- The modern hard hat got its start on this job, and 1995 core tests showed the dam’s concrete outperforms typical mass concrete.
Sigma Construction Inc Leadership Names and Titles

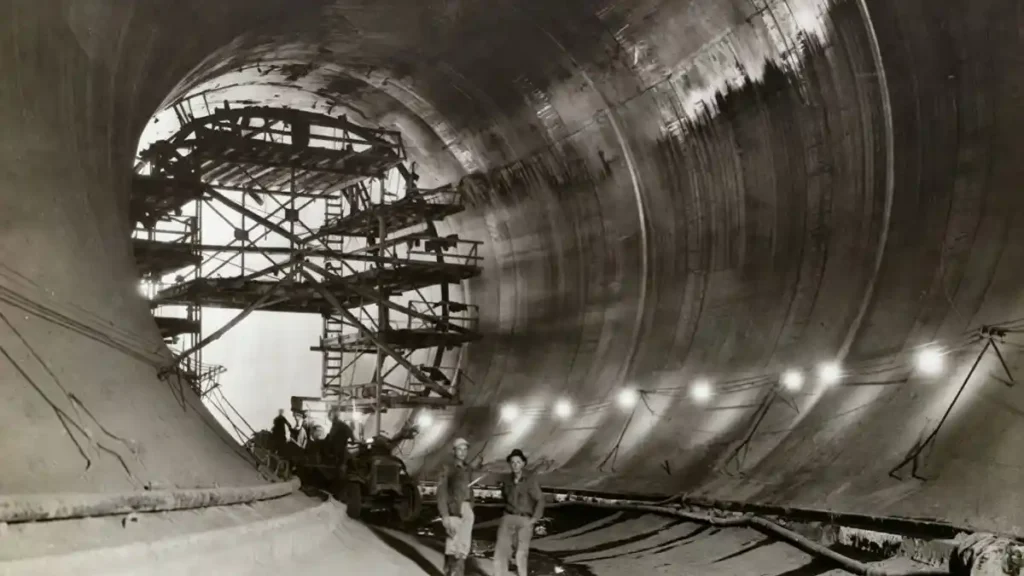

How Many People Died in the Construction of Hoover Dam, Officially?
According to the Hoover Dam entry on Wikipedia, which draws on fatality records from the U.S. Bureau of Reclamation, 112 deaths were reported as associated with the project.
Of those, 96 happened during construction at the site.
The list begins in 1921 with surveyor Harold Connelly, who fell from a barge.
It ends on December 20, 1935, when electrician’s helper Patrick Tierney fell from an Arizona-side intake tower.
Tierney’s father had died surveying the river 13 years earlier, to the day.
Why Is the Real Number Probably Higher?
Another 42 workers were recorded as dying of pneumonia and were left out of the official count.
Workers alleged these were actually carbon monoxide deaths caused by gasoline-powered trucks running in diversion tunnels that reached 140°F (60°C).
No non-workers in Boulder City were recorded as dying of pneumonia during the same period.
Our analysis suggests that anyone asking how many people died in the construction of Hoover Dam should treat 112 as a floor, not a ceiling.
Heat was also deadly.
Sixteen workers and riverbank residents died of heat prostration in the summer of 1931, when daytime highs averaged 119.9°F.
Telefonnummer Christmann & Pfeifer Construction GmbH & Co KG
What Does the Hoover Dam Death Toll Mean for Modern Site Safety?
At its peak in July 1934, the site employed 5,251 workers.
Falling objects were the leading cause of death, which is why high scalers were lowered on ropes to clear loose rock with jackhammers and dynamite.
Some scalers dipped cloth hats in tar and let them harden, and Six Companies soon ordered thousands of “hard boiled hats,” the first hard hats used on a job of this scale.
When clients ask us how many people died in the construction of Hoover Dam, our contractors note that nearly every cause on that list now has a standard control.
The OSHA construction standards cover each one:
- CO monitoring wherever gas-powered saws, pumps, or trowels run in enclosed spaces
- Heat illness plans with water, shade, rest, and acclimatization schedules
- Overhead protection and exclusion zones beneath active lifts
- ANSI Z89.1-rated head protection, as required under 29 CFR 1926.100

How Did Engineers Solve the Mass Concrete Problem?
The first concrete went in on June 6, 1933, and pouring wrapped up on May 29, 1935.
Engineers calculated that a single continuous pour would take 125 years to cool, and the resulting stress would crack the dam apart.
Instead, crews poured interlocking columns up to 50 ft square and 5 ft high, running river water and then refrigerated water through 1-inch steel pipes before grouting them shut.
One myth tied to how many people died in the construction of Hoover Dam claims that workers are buried in the concrete.
The record says otherwise.
Each 8 cu yd bucket raised a form only about one inch, and engineers would never have accepted a flaw that large.
| Factor | Hoover Dam (1933–35) | Modern Practice |
|---|---|---|
| Volume | 3,250,000 cu yd dam; 1,110,000 cu yd in plant and works | Project-specific, often phased |
| Thermal control | Column blocks, 582+ miles of cooling pipe | Pour sequencing and sensors guided by ACI 207 |
| Aggregate | Zoned, from pea gravel to 9-inch stone | Graded mixes with ASR testing |
| Placement | Cableway buckets of 8 cu yd each | Pump trucks, conveyors, precast units |
| Long-term strength | 1995 cores exceeded normal mass concrete | Cylinder testing to specified f’c |
How Will These Concrete Lessons Impact Your Next Build?
If you’ve been following construction technology trends across the Midwest, this won’t come as a surprise.
The same thermal principles now guide footings, mat slabs, and thick precast elements.
The American Concrete Institute remains the go-to reference for mass placements.
- Map placement zones and set lift heights before you schedule a single truck.
- Model heat of hydration with your engineer and confirm the allowable temperature differential.
- Select a cooling strategy, such as low-heat cement, chilled mix water, or embedded pipes.
- Sequence pours so adjacent lifts have time to release heat.
- Install temperature sensors and log readings through the full curing period.
- Seal and document joints, then keep records for the owner.
Speed carries hidden costs.
Hoover Dam finished more than two years ahead of schedule, yet rushed crews left 58 of 393 grout curtain holes incomplete.
Fixing that work took nine years, which is a reminder that how many people died in the construction of Hoover Dam is only one measure of what haste can cost.
Goodyear Data Center Permit 225 Acres Construction Lessons for the Midwest
How Many People Died in the Construction of Hoover Dam Ask a room of contractors how many people died in the construction of Hoover Dam… @HISTORY @GovUsbr @AfterEight020 https://t.co/r2o2yd6HTN
— US News (@Us_news_ways) October 13, 2026
What Should Contractors Take Away?
So, how many people died in the construction of Hoover Dam?
The official count is 112, the likely total is higher, and nearly every death traces back to a hazard we can control today.
We found that the dam’s engineering wins and its safety failures teach the same lesson: plan the pour, protect the crew, and don’t let the schedule win.
For more history, visit the National Park Service’s Hoover Dam overview. Then review your own thermal and safety plans before your next mass pour.
